Grid-Storage Bifurcation: FLNC's Hyperscaler Surge vs. EOSE/SMR Collapse

Prompt v1.0

Fluence Energy's near-doubling in five days on hyperscaler supply agreements and a record $5.6B backlog stands in sharp contrast to Eos Energy's post-earnings crater and NuScale's pre-commercial limbo — three competing grid/storage solutions diverging violently within the same AI-power-demand thesis. Meanwhile, established IPPs CEG and NRG are each down 20–25% from late-2025 peaks, suggesting the market is narrowing its conviction to contract-secured storage leaders rather than speculative power plays.

FLNCEOSESMRCEGNRGVST
TickerCompanySegmentTrend · 13mo30D1Y
FLNCFluence EnergyEnergy Storage Systems⚠️ Emerging Bear+78.2%+427.5%
EOSEEos Energy EnterprisesEnergy Storage & Batteries⚠️ Emerging Bear+34.6%+29.0%
SMRNuScale PowerAdvanced Nuclear⚠️ Emerging Bear+34.9%−28.1%
CEGConstellation EnergyDiversified Renewable Generators⚠️ Emerging Bear+8.3%+12.5%
NRGNRG EnergyIntegrated Retail & Generation⚠️ Emerging Bear−14.6%+16.7%
VSTVistraIntegrated Retail & Generation⚠️ Emerging Bear−3.3%+9.4%

12-month price & trend

FLNC

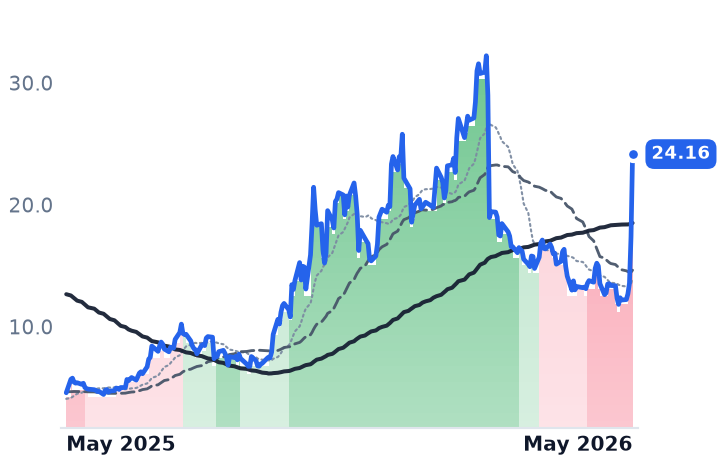

Fluence Energy
24.16
+6.79 (+39.10%)
vs. prior close
Price20d50d150d
FLNC 12-month price
Energy Storage Systems
EOSE

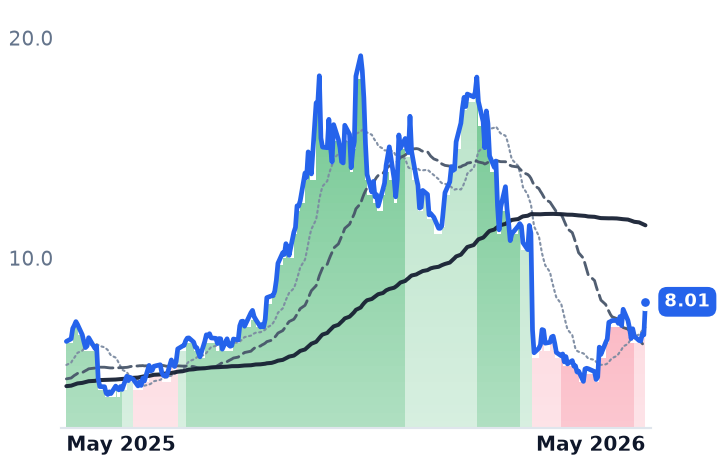

Eos Energy Enterprises
8.01
+1.50 (+23.04%)
vs. prior close
Price20d50d150d
EOSE 12-month price
Energy Storage & Batteries
SMR

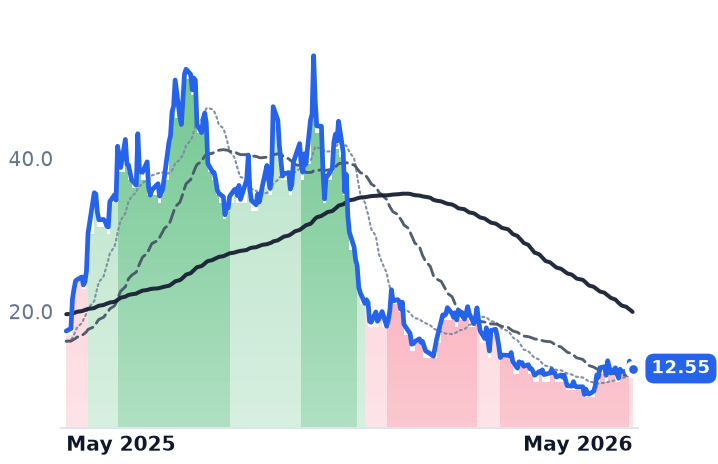

NuScale Power
12.55
−0.36 (−2.79%)
vs. prior close
Price20d50d150d
SMR 12-month price
Advanced Nuclear
TickerMkt capP/EP/E fwdP/SP/S fwdP/GPP/GP fwdEV/EBITDAFCF yld
FLNC$3.8Bn/m1.5x1.1x12.9x9.9xn/m-7.1%
EOSE$2.1Bn/m12.8x6.7xn/m-18.8%
SMR$2.8Bn/m261.9x91.1x432.7xn/m-27.7%
CEG

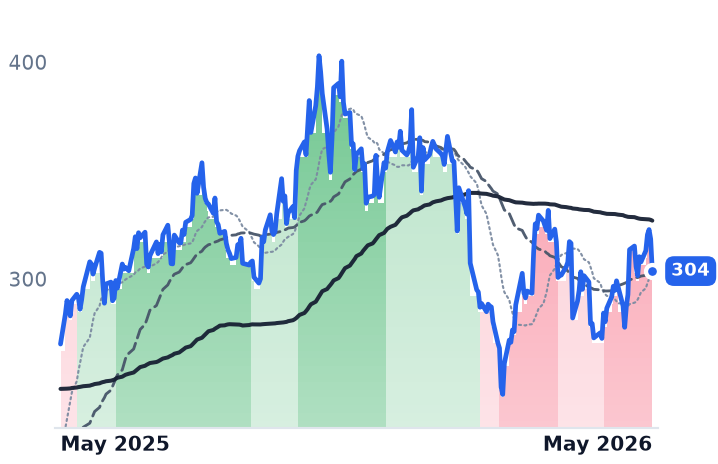

Constellation Energy
304
−14.76 (−4.64%)
vs. prior close
Price20d50d150d
CEG 12-month price
Diversified Renewable Generators
NRG

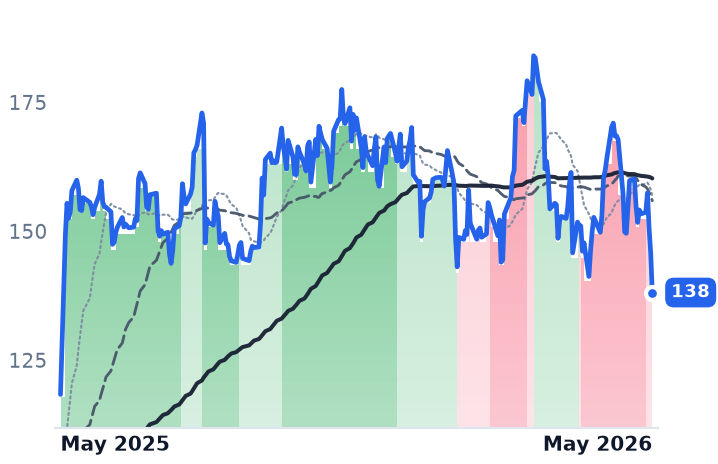

NRG Energy
138
−7.72 (−5.29%)
vs. prior close
Price20d50d150d
NRG 12-month price
Integrated Retail & Generation
VST

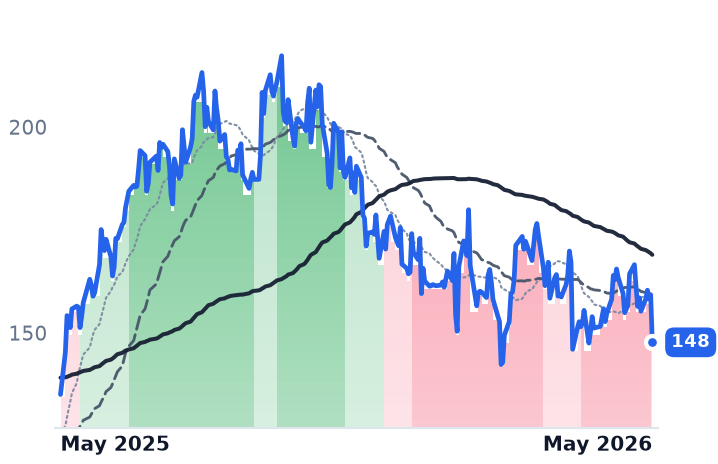

Vistra
148
−11.41 (−7.17%)
vs. prior close
Price20d50d150d
VST 12-month price
Integrated Retail & Generation
TickerMkt capP/EP/E fwdP/SP/S fwdP/GPP/GP fwdEV/EBITDAFCF yld
CEG$101.4B27.5x24.1x3.2x3.1x3.4x3.2x14.7x0.3%
NRG$25.4B31.5x13.5x0.7x0.7x4.2x4.4x11.5x1.4%
VST$47.4B23.5x15.5x3.0x2.0x22.9x15.7x10.3x2.9%

Consensus projections

TickerFY2026EFY2027EFY2028E
FLNCRevenue+29.7%+23.6%+18.1%
EPS−61.9%−292.6%+127.2%
EOSERevenue+104.5%+94.6%+87.8%
EPS−93.2%−73.0%−510.5%
SMRRevenue−26.7%+434.9%+101.2%
EPS−74.7%+33.4%−18.3%
CEGRevenue+35.3%+4.1%+5.2%
EPS+25.2%+13.1%+28.6%
NRGRevenue+17.9%+3.2%+4.4%
EPS+13.9%+23.1%+17.7%
VSTRevenue+20.8%+8.9%+4.9%
EPS+89.5%+20.6%+16.1%

Forward fiscal years only. Blank means no analyst coverage for that year.

What's happening

Fluence Energy (FLNC) surged from ~$12.19 on May 1 to $24.16 on May 8, 2026 — a ~98% five-day move — after Q2 FY2026 earnings reported May 6 delivered two hyperscaler master supply agreements and a record $5.6B backlog. The stock is technically still in a strongly bearish trend band and sits roughly 26% below its February 2026 peak near $32, meaning the violent rally is a recovery-within-a-downtrend rather than a breakout to new highs.

Roth/MKM doubled its price target to $26 and upgraded to Buy, citing order growth as the key driver. Goldman Sachs raised to $22, Canaccord to $28, and JPMorgan hiked to $17 while keeping Neutral — a broad but uneven analyst upgrade cycle. The revenue miss ($464.9M vs. $628M+ consensus) was forgiven; what moved the stock was Fluence's 41.3 GW / 147 GWh pipeline expansion and ~$900M total liquidity, along with reaffirmed FY2026 guidance of $3.2–$3.6B revenue and $40–$60M Adjusted EBITDA, with full-year revenue described as already covered by backlog.

Important context: FLNC reported FY2025 revenue of $2.3B with gross margin improving to 13.1%, and had 85% of FY2026 revenue already secured at that point. The caution flag is that FLNC's YTD performance is still -11%, and the recovery thesis hinges on lumpy quarterly execution as hyperscaler orders convert to shipped revenue. FLNC is also RSI overbought and appears on most-shorted stock lists with elevated short interest, a setup that amplifies both the squeeze and subsequent consolidation risk. A prior red flag: Fluence cut FY2025 guidance by $700M at the midpoint in Q2 2025, blaming tariff-driven project pauses and ~$20M EBITDA impact — illustrating how quickly contract timing can shift.

The EOSE setup: resolved going-concern, but dilution looms

Eos Energy (EOSE) is a different beast. Its ~56% six-month decline traces directly to a Q4 2025 earnings miss — $58M revenue vs. a ~$94M consensus — that triggered a ~57% single-session crash in late February 2026. Yet full-year 2025 revenue of $114.2M represented 7x year-over-year growth, and 2026 guidance of $300–$400M implies another 3–4x step-up.

The going-concern overhang is formally resolved: EOSE ended 2025 with $624.6M cash after a $600M convertible notes and equity raise, with 2 GWh annualized production capacity achieved. The headline net loss of $969.6M was driven by $746.8M of non-cash fair value adjustments, not cash operating losses. Backlog stands at $701.5M (2.8 GWh) across 8 customers, and the DOE Loan Programs Office committed $303.5M total to support 8 GWh capacity by 2027, with the second advance of $22.7M already drawn.

However, EOSE is seeking shareholder authorization to expand authorized shares from 600M to 800M and add 5M shares to its incentive plan at its June 2026 annual meeting — a structural dilution overhang that is a real near-term constraint on any re-rating. The stock has bounced from an April trough near $4.48 to $8.01 and shifted from strongly bearish to mildly bearish, but remains well below its pre-earnings level near $13.

SMR: structurally weakest, longest runway to revenue

NuScale (SMR) is down ~56% over six months, from ~$28.43 in November 2025 to $12.55 on May 8, stabilizing from April lows near $9.16. Unlike FLNC and EOSE, the decline isn't post-earnings punishment — it's a slow repricing of a pre-commercial story. NuScale received NRC design approval for its 77 MWe module in May 2025, making it the only SMR design NRC-approved, but no binding commercial contracts have been signed. The flagship UAMPS project in Idaho was cancelled in November 2023 after cost estimates ballooned from $3.6B to $9.3B and target electricity cost rose to $89/MWh from $55/MWh.

NuScale's Romania project final investment decision may slip to early 2027, and even after a commercial contract is signed, the NRC licensing process for an actual plant can take 30+ months. First revenue is years away.

The IPP backdrop: AI-power thesis broadly repriced

The peer context amplifies FLNC's differentiation. Constellation Energy (CEG) has fallen ~24% from its October 2025 peak to $303.63 and has been in a persistent strongly bearish trend band since early March. NRG Energy is down ~23% over six months to $138.11, sitting in mildly bearish. These established power providers — once the primary beneficiaries of the AI electricity narrative — are being repriced as the market grows skeptical that datacenter load growth translates directly into margin expansion for utilities. In that context, FLNC's hyperscaler-contracted storage story represents a more direct and defensible claim on the same capex cycle.

The structural divergence in plain terms

FLNC has contract-secured backlog, hyperscaler relationships, and near-term revenue visibility — but carries post-squeeze consolidation risk and a track record of lumpy quarterly delivery. EOSE has resolved its existential funding risk and owns a differentiated zinc chemistry, but faces execution-versus-guidance scrutiny and near-certain dilution. SMR has regulatory credibility but no commercial contracts, a history of cost overruns at scale, and a decade-plus commercialization timeline. The three names share the same demand thesis but represent fundamentally different risk profiles and time horizons within it.
